Henrik Kniberg's Blog, page 9

November 14, 2012

Scaling Agile @ Spotify with Tribes, Squads, Chapters & Guilds


Dealing with multiple teams in a product development organization is always a challenge!


One of the most impressive examples I’ve seen so far is Spotify. I’ve had the pleasure of working with Spotify on and off ever since the company was founded, and it’s one of the few companies I’ve seen with a truly agile culture. Spotify has grown a lot lately and now has hundreds of developers divided into 30 agile teams spread over 4 cities in 3 timezones. So how is this managed?


Check out the article: Scaling Agile @ Spotify with Tribes, Squads, Chapters and Guilds. I wrote it together with Anders Ivarsson, one of the agile coaches that I’m working with (Spotify has a truly awesome group of coaches!).


Translations:



French
Russian
Spanish
 •  0 comments  •  flag
Share on Twitter
Published on November 14, 2012 03:04

November 8, 2012

Lean from the Trenches @ Øredev

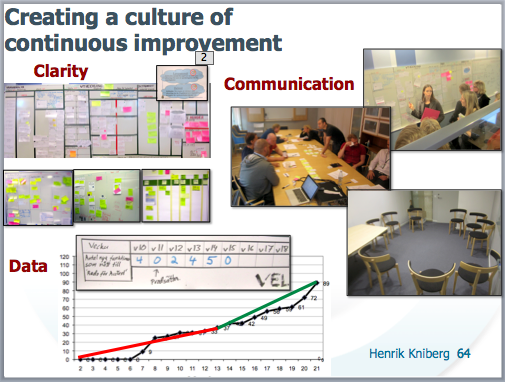

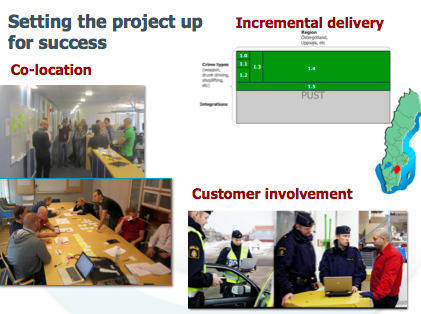

Here are the slides for my talk “Lean from the Trenches” at Øredev, Malmö. And here is the book/ebook, in case you want more details. There may also be some copies left at the conference bookstore.


Thanks for attending!


 •  0 comments  •  flag
Share on Twitter
Published on November 08, 2012 02:32

October 25, 2012

Agile Product Ownership in a nutshell

This is basically a 1 day product ownership course compressed into a 15 minute animated presentation.



There’s obviously more to product ownership than this, so see this is a high level summary. Download the complete drawing here.


Special thanks to Alistair Cockburn, Tom & Mary Poppendieck, Jeff Patton, Ron Jeffries, Jeff Sutherland, and Michael Dubakov for providing many of the models, metaphors, and ideas that I use in this presentation.


See below for a full transcript. But I recommend watching the video instead of reading the transcript. The video is 100% visual, the transcript is 0% visual…



———


Let’s talk about Agile software development from the perspective of the Product Owner.


Here’s Pat. She’s a product owner. She has a product vision that’s she’s really passionate about. She doesn’t know the details of what her product is going to do, but she knows why we’re building the product, what problem it is going to solve, and for whom. She talks about it all the time.


Here are the stakeholders. The people who are going to use, support, or in any way be affected by the system being developed. Pat’s vision is that these people will love our system and use it all the time.


The stakeholder needs are expressed as user stories. For example in a flight booking system, people need to be able to search for a flight. That would be one user story. Stories often correspond roughly to a feature, or a use case. The stakeholders have lots of ideas, Pat helps them divide these into fairly distinct user stories.


Now, somebody has to BUILD the system. Here they are, the development team.


Since this is an agile team, they don’t save up for a big bang release at the end. Instead, they release early and often. They usually release 4-6 stories per week, so that is their capacity. It is easy to measure, just count the number of stories released per week. Some stories are big, so they count as two, some are small and count as a half. But all in all, it adds up to about 4-6 stories per week.


In order to maintain this pace, and not get bogged down by manual regression testing, the team invests heavily in automated testing and continuous integration. Every feature has automated acceptance tests, and most of the code has automated unit tests.


The problem is, here are bunch of stakeholders asking for all kinds of stuff, and they sure aren’t going to be limited to 4-6 ideas per week. They have LOTS of ideas and LOTS of wishes. And every time we deliver something to them, they will get even more ideas and ask for even more stuff.


So what happens if we try to do everything they ask for? We’ll get overflow. Suppose the team starts working on 10 new stories per week. If the input is 10, and the output is 4-6, the team will get overloaded with work. That will cause multitasking, demotivation, and ultimately lower output and lower quality. It’s a lose-lose proposition.


It’s like trying to shove more paper into a printer to make it print faster. Or shoving more cars onto a crammed highway system. It doesn’t work, it just makes things work. It’s a basic law of the universe – if Input is greater than the Output, you unavoidably get overcrowding or leaks.


The Scrum and XP way of avoiding this problem is called “yesterday’s weather”. The team says “well, the past few weeks we’ve finished 4-6 features per week. So which 4-6 features shall we build this week?.”. The product owner’s job is to figure out, out of all the possible stories in the whole universe, which 4-6 shall we deliver next?


The Kanban way is to limit work-in-progress. Suppose the team decides that 5 is the optimal number of stories to be working on simultaneously, just enough to keep everyone busy without causing overload. So they decide that 5 is their WIP limit. Whenever they finish one story, they will accept one new story, thereby making sure they never break the limit of 5 ongoing stories.


Both of these approaches work fine. And they will cause a queue to form in front of the team, which in Scrum is called a Product Backlog.


This queue needs to be managed. If stakeholders keep asking for 10 new stories every week, and the teams deliver 4-6, the queue will keep getting longer and longer. Before you know it, you have a 6 month long wish list in the backlog. That means that, on average, every story that the team delivers is something that somebody asked for 6 months ago. How agile is that?


There is only one way to stop the queue from going out of the control. That is the word No. It is the most important word for a product owner, and Pat practices it every day in from of the mirror. Saying yes to a new feature request is easy. The most important job for a product owner is to decide what NOT to build, and take the consequences of that decision.


The product owner decides what goes in, and what goes out. The product owner also decides the sequencing – what do we build now, what do we build later? This is a hard job, and needs to be done in collaboration with the team and stakeholders.


——–


To be able prioritize, the product owner must have some idea of the value of each story, as well as the size. Some stories are critically important, others are really just bonus features. Some stories take just a few hours to build, others take months.


Guess what the correlation is between story value and story size? That’s right – None! Bigger doesn’t mean better. Think of any system that you have used, and I bet you can think of at least one really simple feature that is very important, that you use every day. And I bet you can think of least one huge complicated feature that is totally unimportant – like that silly paperclip guy that was in Microsoft office a few years ago.


Value and size is what helps Pat prioritize intelligently.


These two stories are roughly the same size, but have different value. So build this one first. And over here- these two stories have roughly the same value, but different size. So build this one first. And so on.


But wait a sec – how does she know the value of a story? How does she know the size? Well, here’s the bad news – she doesn’t. It’s a guessing game.


And it’s game that everyone is involved in! Pat continuously talks to stakeholders to find out what they value. She continuously talks to the team to find out what they think is big or small, in terms of implementation effort. These are relative guesses, not absolute numbers. I don’t know what this apple weighs, or that strawberry. But I’m pretty sure that the apple weighs at least five times as much, and that the strawberry tastes better (to me). And that’s all Pat need to know in order to prioritize the backlog! It’s pretty cool that way.


At the beginning of a new project our guesses will inevitably suck. But that’s OK, the biggest value is really in the conversations rather than in the actually numbers. And every time the team delivers something to real users, we learn something and get better at guessing both value and size. That’s why we continuously prioritize and estimate. Trying to get it all right from the beginning is pretty dumb, because that’s when we know the least. The feedback loop is our friend.


——–


Prioritization is not enough though. In order to deliver early and often, we need to break the stories down into bite-sized pieces, preferably just a few days of work per story. We want this nice funnel shape, with small, clear stories at the front and more vague stories at the back. By doing this break-down in a just-in-time fashion, we can take advantage of our latest insights about the product and the user needs.


All this stuff I’ve been talking about – estimating the value and size of stories, prioritizing, splitting – all that is usually called “backlog grooming”. Pat runs a backlog grooming workshop every wednesday from 11:00 – 12:00. The whole team is usually there, and sometimes a few stakeholders as well. The agenda varies, sometimes the focus is on estimation, sometimes on splitting stories, and sometimes on writing acceptance criteria for a story.


I hope you’re noticing the theme here. Communication! Product Ownership is really all about communication. When I ask experienced product owners what it takes to succeed, they usually emphasize passion and communication. It is no coincidence that the first principle of the agile manifesto is “Individuals and Interactions over Processes and Tools”.


So the PO’s job is not to spoon-feed the team with stories. That’s boring and ineffective. Pat, instead, makes sure everybody understands the vision, that the team is in direct contact with stakeholders, and that there is a short feedback loop in terms of frequent deliveries to real users. That way the team learns and can make daily tradeoff decisions on their own, so Pat can focus on the big picture.

——–


There are number of tradeoffs that need to be made by Pat and the team. Let’s look at a few.


First of all, there’s the tradeoff between different types of value. Early on in a project, uncertainty and risk is our enemy.


There’s business risk: are we building the right thing? There’s social risk: can these people build it? There’s technical risk – will it work on the platform that we want to run it on? Will it scale? And there’s cost and schedule risk. Can we finish the product in a reasonable amount of time, for a reasonable amount of money?


Knowledge is the opposite of risk. So when uncertainty is high, our focus is knowledge acquisition- we focus on things like user interface prototypes and technical spikes, or experiments. Not too exciting for the customers, but still valuable because we are reducing risk.


From a customer value perspective, the curve looks like this in the beginning.


As uncertainty is reduced, we gradually focus more and more on customer value. We know what we’re going to build and how, so just do it! And by doing the highest-value stories first, we get this nice steep value curve.


And then, gradually, the value curve starts flattening out. We’ve built the most important stuff, now we’re just adding the “bonus features”, the toppings on the ice cream. This is a nice place to be, because, at any point, Pat and the team may decide to “trim the tail” and move on to another, more important project, or start on a whole new feature area within the same product. That is business agility.


So when I talk about Value here, I mean Knowledge value + Customer value. And we need to find a tradeoff between these two.

——–


Another tradeoff is short term vs long term thinking. What should we build next? Should we do that urgent bug fix, or build that awesome new feature that will blow the users away, or do that difficult platform upgrade that will enable faster development in the future? We need to continuously balance between reactive work and proactive work, or fire-fighting and fire-prevention.


This is related to another tradeoff. Should we focus on “building the right thing”, “building the thing right”, “building it fast”? Ideally we want all three, but it’s hard to find the balance. Suppose we are here – trying to building the perfect product, with the perfect architecture. If we spend too much time to trying to get it perfect, we may miss the market window or run into cash-flow problems.


Or suppose we are here, rushing to turn a prototype into a usable product. Great for the short term, perhaps, but in the long term we’ll be drowning in technical debt and our velocity will approach zero.


Or suppose we are here, building a beautiful cathedral in record time. Except that the users didn’t need a cathedral, they needed a camper van.


There is a healthy tension here between the Scrum roles. POs tend to focus on building the right thing. Teams tend to focus on building the thing right. And Scrum masters, or agile coaches, tend to focus on shortening the feedback loop.


Speed is worth emphasizing. Because a short feedback loop will accelerate learning, so you will more quickly learn what the right thing is, and how to build it right. However, all three perspectives are important so, keep trying to find the balance.


Finally, there is the tradeoff between new product development and old product improvement. Product Backlog is a confusing term, because it implies that there is only one product. And project is confusing term, because it implies that product development “ends”. A product is never really “finished” there’s always maintenance and improvements to be done, all the way until the product reaches end of life and is shut down.


So when a team starts developing a new product, what happens to their last one? Handing off a product from one team to another is expensive and risky. A more common scenario is that the team continues maintaining the old product while developing the new one. So it’s not really a product backlog, it’s more like a team backlog – a list of stuff that the product owner wants this team to build, and it can be a mix of stuff for different products. And the product owner needs to continuously make tradeoffs between these.


——–

Once in a while, a stakeholder will call Pat and say “Hey, when will my stuff be done?” or “How much of my stuff will be done by christmas?”. As PO, Pat is responsible for expectations management! Or, more importantly, realistic expectations management. That means no lying. I know, it’s tough, but who said Agile was easy?


It’s not really that hard to make a forecast, as long as it doesn’t have to be exact. If you measure the velocity of your team, or the combined velocity of all your teams, you can draw a story burnup chart. The chart shows the cumulative number of stories delivered over time (or story points if you prefer).


Note the difference. This curve shows output. That curve shows outcome. That’s the output, and that’s the outcome that we hope it will achieve. Our goal is not to produce as much output as possible. Our goal is reach the desired outcome, using the least possible output. Less is more.


Look at the burn up chart and draw an optimistic and pessimistic trend line. You can do it using fancy statistics voodoo, or you can just draw it visually. The gap between these lines is of course related to how wavy and unpredictable your velocity is. That tends to stabilize over time, so our cone of uncertainty should get tighter and tighter.


OK, so back to expectations management.


Suppose the stakeholders ask Pat “When will all of THIS stuff be done?”. “When will we be here?”. That’s a fixed-scope, variable time question. Pat uses the two trend lines to answer. “Most likely sometime between April and mid-May”.


Suppose the stakeholders ask Pat “How much will be done by christmas?”. That’s a fixed time, variable scope question. The trend lines tell us “We’ll most likely finish all these, some of these, and none of these.”


Suppose the stakeholders say “Can we THESE features by christmas”. That’s a fixed time, fixed scope question. Looking at trend lines, Pat says “Nope, sorry, it ain’t gonna happen”, followed by “here’s how much we can get done by christmas” or “here’s how much more time we need”. It’s generally better to reduce scope than to extend time, because if reduce scope first, we still have the option to extend the time later and add the rest of the stories. Vice versa doesn’t work, because, darnit, we can’t turn the clock backwards! Time is rather annoying that way, isn’t it. Pat makes the choice easy by saying “we could deliver something here, and the rest later. Or we could deliver nothing here and the rest later. What do you prefer?”


The calculations are simple to do, so Pat updates the forecast every week.


The important thing here is that Pat is using empirical data to make the forecast, rather than wishful thinking. And she is being honest about the uncertainty. I said no lying right? This is a very honest way of communicating with stakeholders, and they usually appreciate that a lot. If your organization doesn’t like truth and honesty, it won’t like agile.


A word of warning though. If the team is accumulating technical debt – if they’re not writing tests, and not continuously improving the architecture – then the they will get slower and slower over time, and the story burnup curve will flatten out. That makes forecasting almost impossible. So the team is responsible for maintaining a sustainable pace, and Pat avoids pressuring them into taking shortcuts.

——–

What if we have a larger project with multiple teams? Instead of one team with 5 people here, we might have 3 teams. And we might have several product owners, each with their own backlog for a different part of the product.


Overall, the model is really the same. We still need capacity management, we still need stakeholder communication, we still need product owners who can say No, we still need backlog grooming. Velocity is the sum of all output, and can be used for forecasting. Or make a separate forecast for each team, if that makes more sense.


In a multi team scenario, however, the POs have an important additional responsibility – to talk to each other! We should organize the teams and backlogs to minimize dependencies. But there will always be SOME dependencies. So there needs to be some kind of sync between the product owners so that we build things in a sensible order, and avoid sub optimization. In large projects, this usually calls for some kind of Chief Product Owner role to keep the product owners synchronized.


OK, that’s it! Agile product ownership in a nutshell.


———–

 •  0 comments  •  flag
Share on Twitter
Published on October 25, 2012 12:27

October 6, 2012

Agile @ Home (AgileEE keynote)

Here are the slides for my third(!) keynote at Agile Eastern Europe. The guy who was supposed to do the afternoon keynote couldn’t make it, so I was invited to jump up and do another one (talked about Spotify, but I don’t yet have permission to publish those slides, sorry). And then that one finished early, so I filled in the last 20 minutes with this short talk about Agile @ Home. Three keynotes in one day must be some kind of record :)


Thanks for listening, and glad to see that so many of you were so excited about the idea of using Agile outside of work :)






 •  0 comments  •  flag
Share on Twitter
Published on October 06, 2012 23:34

Lean from the Trenches keynote @ AgileEE, Kiev

Here are the slides for my keynote “Lean from the Trenches” at Agile Eastern Europe, Kiev. And here is the book/ebook, in case you want more details. Thanks for attending!


 •  0 comments  •  flag
Share on Twitter
Published on October 06, 2012 02:12

September 20, 2012

Agile Evening with Alistair and Henrik

On Tuesday Oct 2 Alistair Cockburn and I are hosting a free evening event at Crisp.


I’ll be talking a bit about my current client Spotify, which has a cool scaling approach with ”tribes”, “squads”, “guilds”, and “chapters”. Then Alistair will talk about whatever topic the participants choose. Then we’ll have discussions and finger food.


Feel free to join us!


 •  0 comments  •  flag
Share on Twitter
Published on September 20, 2012 07:34

Interviewed by InfoQ

Here’s an interview by InfoQ. I talked about my books, my travels, the agile manifesto translation project, coaching coaches, agile trends, and various other stuff. The interviewer (Craig Smith) had a great set of questions, and I’m pretty happy with my answers :)

 •  0 comments  •  flag
Share on Twitter
Published on September 20, 2012 02:08

September 10, 2012

Advanced Agile with Alistair Cockburn, Oct 1-2

On Oct 1-2 Alistair Cockburn is in Stockholm teaching Advanced Agile together with me. He has been here twice before and course reviews have been great! Alistair has a very pragmatic down-to-earth style, while maintaining the theoretical depth needed for an advanced course. He’s not only a Fun Guy, he’s the guy who (literally) wrote the book on Agile Software Development, and co-created the agile manifesto!


Join us!



Teaching at Crisp



Alistair and his bass mentor :)

 •  0 comments  •  flag
Share on Twitter
Published on September 10, 2012 05:37

September 9, 2012

Using CloudBees for teaching XP practices

We are doing a course called “Certified Scrum Developer”.  We are of course proud of being one of the few eligible by the Scrum Alliance to hold such a course. But what matters most to us is teaching some modern development practices. The certificate bit is more of a bonus.


Crisp had recently its fifth installment of a code camp, the “Crisp Hack Summit”. It is an occasion for everyone at Crisp to go bananas on some project of their liking. We took the chance to work on the technical platform for the CSD course.  We know from experience that you can loose a lot of valuable lecture time if  the technical environment decides to hassle. Murphy, will you be there?



There are several things at play. We want to have exercises where the students program on their own laptops with their favourite IDE. They should work in teams so we need a source code repository. After each sprint, the code should be running in production as this will be our definition of done.  Why settle for less?


There are of course many ways to solve this, but we decided to rely on a cloud service. It is a course on modern development, after all. Of all cloud services that we know, CloudBees suits us best as it provides us with:



A source code repository, where we choose the Git option.
A build service in the form of a Jenkins. We set up a job to start when there is a check in into the repository.
A run service integrated with the build service such that a successful build can be deployed immediately.

There is a lot more to their offering but these were the main points that we saw met our needs.


So how does this help us fight the law of  Murphy? Well, we are relying on an around the clock cloud service which means that as long as we have an internet connection, we can be pretty sure that we have the above services available.


But that is not enough, the students must be able to get in the loop with doing continuous deployment so we will challenge them with a task that they are supposed to complete before attending the course. There will be an application running in the cloud and their job will be to check it out, change it and check in. The application should build and deploy with no problem. This will iron out initial problems and get rid of administration such as setting up accounts.


When in class, students will have one repository per team. A team will be  2- 3 pairs working in sprints. There will be a backlog with stories for the team to pull in to the sprint. The teams will be expected to do unit and acceptance testing. Of course, after the end of each sprint, there is supposed to be a demo. As said, the definition of done includes deploying to production so you’re not done until then.


We are quite excited about this and looking forward to January when we will see how this turned out in practice. Wish us luck!


For more on cloud computing, click the “cloud” tag below.

 •  0 comments  •  flag
Share on Twitter
Published on September 09, 2012 15:00
